TPAC – Phoenix Precast Facility
Location of the precast/prestressed beam fabrication.
Address:
TPAC
3052 S 19th Ave
Phoenix, AZ 85009

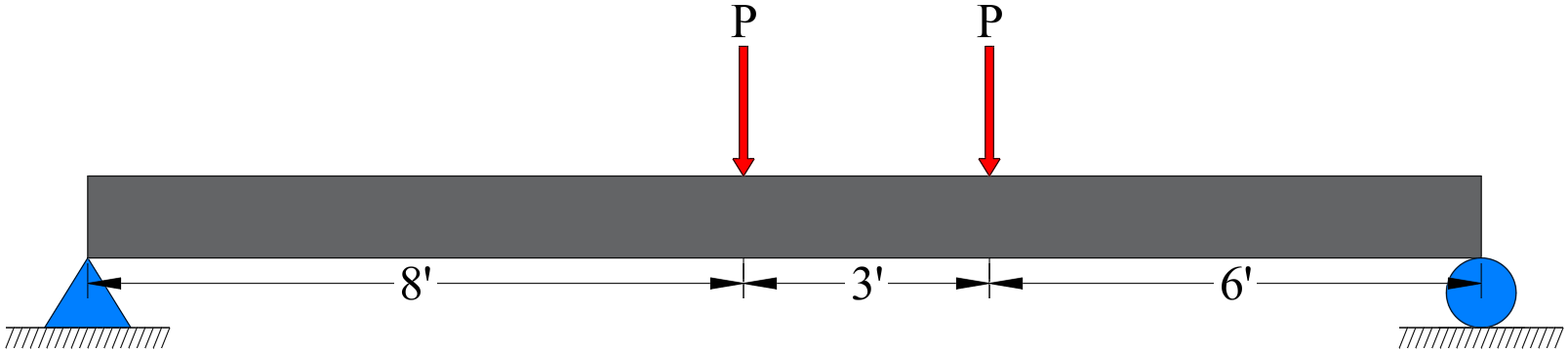

The PCI Big Beam project focuses on designing, coordinating fabrication for, and testing a prestressed concrete beam that satisfies competition requirements for strength, serviceability, and constructability. The beam is designed for the standardized loading configuration specified by PCI and will be fabricated at TPAC’s precast facility before testing at NAU.
Beamline Structural develops the analytical model, supports fabrication and transport logistics, and compares measured test results to predicted cracking load, ultimate capacity, and midspan deflections.
The project is based at Northern Arizona University in Flagstaff, Arizona. Beam fabrication is performed at TPAC’s precast facility in Phoenix, with the completed beam transported to the NAU Engineering building and Structural Laboratory for storage, instrumentation, and full-scale testing.
Location of the precast/prestressed beam fabrication.
Address:
TPAC
3052 S 19th Ave
Phoenix, AZ 85009
Location of beam storage, instrumentation, and full-scale testing.
Address:
NAU Engineering Building (Building 69)
2112 S Huffer Ln
Flagstaff, AZ 86011
The project scope is divided into ten major tasks, including research and preparation, beam analysis and design, engineering shop drawings, fabrication and site visits, delivery and setup, beam testing, documentation of project impacts, deliverables, and project management. The schedule begins on October 21, 2025 and extends through May 8, 2026 for a total project duration of 199 days.
| Task Name | Start | Finish |
|---|---|---|
| Task 1 – Research & Preparation | Oct 21, 2025 | Nov 20, 2025 |
| Task 2 – Beam Analysis & Design | Dec 10, 2025 | Feb 19, 2026 |
| Task 3 – Engineering Shop Drawings | Feb 20, 2026 | Mar 4, 2026 |
| Task 4 – Fabrication & Engineer’s Site Visit | Mar 20, 2026 | Apr 21, 2026 |
| Task 5 – Delivery & Setup | Apr 9, 2026 | Apr 21, 2026 |
| Task 6 – Beam Testing | Apr 21, 2026 | Apr 23, 2026 |
| Task 7 – Finalize Report & Submit to PCI | Apr 24, 2026 | May 8, 2026 |
| Task 8 – Project Impacts | Apr 24, 2026 | Apr 27, 2026 |
| Task 9 – Deliverables | Feb 2, 2026 | May 8, 2026 |
| Task 10 – Project Management | Oct 21, 2025 | May 8, 2026 |
Full Gantt Chart: View Schedule (PDF)
| Task Name | SENG (hr) | STEG (hr) | INT (hr) | LBT (hr) | Total Hours |
|---|---|---|---|---|---|
| Task 1 – Research & Preparation | 0 | 10 | 20 | 0 | 30 |
| Task 1.1 Technical Research | 5 | 10 | |||
| Task 1.2 Material Testing Plan | 5 | 10 | |||
| Task 2 – Beam Analysis & Design | 20 | 145 | 82 | 0 | 247 |
| Task 2.1 Analysis of Load and Material | |||||
| Task 2.1.1 Calculate Beam Initial Conditions | 10 | 10 | |||
| Task 2.1.2 Select Concrete Mix for Design | 10 | 2 | |||
| Task 2.2 Create Analysis Spreadsheet | 5 | 20 | 10 | ||
| Task 2.3 Design Decision Matrix | 5 | 15 | 5 | ||
| Task 2.4 Select Best Design | |||||
| Task 2.4.1 Determine Cross-Section Dimensions | 20 | 15 | |||
| Task 2.4.2 Design Prestressing Layout | 15 | 15 | |||
| Task 2.4.3 Refine Beam Dimensions | 15 | 10 | |||
| Task 2.4.4 Evaluate Performance Against Design Criteria | 5 | 15 | 10 | ||
| Task 2.4.5 Refinement of Final Beam Design | 5 | 25 | 5 | ||
| Task 3 – Engineering Shop Drawings | 5 | 30 | 20 | 0 | 55 |
| Task 3.1 Create Shop Drawings | 25 | 10 | |||
| Task 3.2 Internal Review | 5 | 5 | 5 | ||
| Task 3.3 External Review | 5 | ||||
| Task 4 – Fabrication & Engineer's Site Visit | 10 | 6 | 16 | 17 | 49 |
| Task 4.1 Beam Fabrication & Observation | 2 | 2 | 5 | ||
| Task 4.2 Cylinder Testing & Beam Predictions | |||||
| Task 4.2.1 One-Day Test | 1 | 3 | |||
| Task 4.2.2 Seven-Day Test | 1 | 3 | |||
| Task 4.2.3 Fourteen-Day Test | 1 | 3 | |||
| Task 4.2.4 Twenty-One-Day Test | 1 | 3 | |||
| Task 4.2.5 Day of Testing Test | 2 | 2 | 2 | 5 | |
| Task 4.3 Final Beam Predictions | 6 | 2 | 5 | ||
| Task 5 – Delivery & Setup | 5 | 5 | 10 | 5 | 25 |
| Task 5.1 Transportation | 5 | 5 | |||
| Task 5.2 Testing Preparation | 5 | 5 | 5 | ||
| Task 6 – Beam Testing | 6 | 0 | 8 | 0 | 14 |
| Task 6.1 Load Testing on Beam | 2 | 3 | |||
| Task 6.2 Analyze Test Results | 4 | 5 | |||
| Task 7 – Finalize Report & Submit to PCI | 5 | 15 | 40 | 0 | 60 |
| Task 8 – Project Impacts | 1 | 2 | 5 | 2 | 10 |
| Task 9 – Deliverables | 8 | 14 | 104 | 0 | 126 |
| Task 9.1 30% Project Progress Report | 1 | 2 | 16 | ||
| Task 9.2 60% Project Progress Report | 1 | 2 | 16 | ||
| Task 9.3 90% Project Progress Report | 1 | 2 | 16 | ||
| Task 9.4 Final Presentation | 1 | 2 | 16 | ||
| Task 9.5 Final Project Report | 4 | 6 | 40 | ||
| Task 10 – Project Management | 5 | 24 | 24 | 24 | 77 |
| Task 10.1 Meetings | 4 | 20 | 20 | 20 | |
| Task 10.2 Tracking Project Progress | 1 | 4 | 4 | 4 | |
| Total Hours | 59 | 234 | 284 | 46 | 693 |
The total estimated cost of engineering services is $82,787, which includes personnel labor, travel, structural laboratory rental and consumables, software licensing, forklift and operator time, and subcontracted beam fabrication and delivery by TPAC.
| Item | Unit | Quantity | $ / Unit | Cost |
|---|---|---|---|---|
| 1.0 Personnel | ||||
| SENG | HR | 59 | $275 | $16,225 |
| STEG | HR | 234 | $140 | $32,760 |
| INT | HR | 284 | $65 | $18,460 |
| LBT | HR | 46 | $70 | $3,220 |
| Total Personnel | HR | 693 | – | $70,665 |
| 2.0 Travel | ||||
| Mileage Rate | MILE | 288 | $0.15 | $43 |
| Sedan Rental | DAY | 1 | $40.00 | $40 |
| Total Travel | $83 | |||
| 3.0 Supplies | ||||
| Lab Rental + Consumables | DAY | 6 | $100 | $600 |
| Software Licensing | WEEK | 16 | $93 | $1,488 |
| Forklift and Operator | HR | 2 | $300 | $600 |
| Total Supplies | $2,688 | |||
| 4.0 Subcontract | ||||
| TPAC | LS | 1 | $10,000 | $10,000 |
| Combined Total | $83,436 | |||
